Financial metrics in project management

Understanding the financial aspects is key to ensuring a project’s success and sustainability. The four core financial metrics that stand as the bedrock of project finance are Cost, Budget, Revenue, and Profit. Each metric serves as a lens through which the financial health and performance of a project can be assessed.

For delivery teams, the forecasting layer on top of those four bedrock metrics is estimate to complete (ETC): the remaining-cost view that connects earned-value formulas to weekly staffing and margin decisions.

The four core financial metrics that stand as the bedrock of project finance are Cost, Budget, Revenue, and Profit. Each metric serves as a lens through which the financial health and performance of a project can be assessed.

Although these metrics are often discussed separately, they are closely connected. Understanding how they influence one another makes it much easier to evaluate a project’s financial health.

Diagram showing the relationship between Budget, Cost, Revenue, and Profit in project financial management. Cost

Cost refers to the total expenses incurred during the execution of a project. This includes materials, labor, overheads, and any other expenses directly related to the project. Effective cost management is crucial for keeping the project within budget.

There’s no single formula for total Cost since it aggregates all expenses. However, tracking individual costs can be summarized as

Total Cost = Materials Cost + Labor Cost + Overhead Cost + Other Expenses

Budget

The Budget represents the financial plan for the project, outlining the total money allocated for all aspects of the project. It serves as a financial blueprint, setting the limits for project expenditure.

Similar to Cost, the Budget is an aggregate figure rather than the result of a specific formula. It’s determined during the project planning phase based on estimated costs:

Total Budget = Estimated Costs + Contingency Reserves

Revenue

Project revenue is the total income generated from the project. This can include sales, funding, or any other income streams related to the project’s outcomes. It’s a critical metric for understanding the project’s financial contribution to the organization.

Total Revenue = (Unit Price x Quantity Sold) + Other Income

Profit

Profit, or net profit, is the financial gain after subtracting all costs from the total revenue. It’s the ultimate indicator of the project’s financial success, showing the actual economic benefit derived from the project.

Profit = Total Revenue – Total Cost

The 15 most important additional finance metrics in project management

Flowchart illustrating the project financial lifecycle from estimating costs and creating a budget to generating revenue and analyzing financial performance. While Cost, Budget, Revenue, and Profit are the clearest, most popular, and critical figures for a project’s finances, below are 15 additional project financial metrics and formulas every project manager should be aware of, measure, and track.

Project financial metrics generally fall into six categories, each helping managers answer a different financial question, from staying on budget to forecasting profitability. These project metrics offer valuable insights into financial performance, ensuring that the project remains within budget and is completed in accordance with its financial constraints.

Category Metric Measures Why it matters Formula
Planning BAC
Budget at Completion
Approved project budget Defines the project’s financial baseline Approved Budget
Performance CPI
Cost Performance Index
Cost efficiency Shows if you’re over or under budget EV ÷ AC
SPI
Schedule Performance Index
Schedule efficiency Shows if work is ahead or behind schedule EV ÷ PV
EVA
Earned Value Analysis
Overall project performance Combines cost and schedule health Uses CPI + SPI
Forecasting EAC
Estimate at Completion
Forecasted total cost Predicts final project cost BAC ÷ CPI
ETC
Estimate to Complete
Remaining project cost Estimates how much funding is still needed EAC − AC
VAC
Variance at Completion
Budget variance Forecasts budget overrun or savings BAC − EAC
Profitability ROI
Return on Investment
Investment profitability Measures financial return (Profit ÷ Cost) × 100%
NPV
Net Present Value
Project value today Evaluates long-term financial viability Discounted Cash Flow
Payback Period Investment recovery time Shows how quickly investment is recovered Cash Flow Analysis
IRR
Internal Rate of Return
Expected return Compares project attractiveness NPV = 0
Billing WIP
Work in Progress
Unbilled completed work Prevents revenue leakage (1 − Billed ÷ Total Billing) × 100%
Resource Efficiency Utilization Rate Resource utilization Measures billable capacity usage Billable Hours ÷ Available Hours
Realization Rate Billable time captured Measures billing effectiveness Billed Hours ÷ Billable Hours
Realized Rate Effective billing rate Shows actual earning rate per resource Realization Rate × Billing Rate

Cost Performance Index (CPI)

This project financial metric gauges how effectively the project manages its budget by comparing planned spending with actual expenditure. A CPI above 1 indicates the project is under budget, while a value below 1 indicates overspending.

CPI = EV ÷ AC

Where:

  • EV = Earned Value (budgeted cost of completed work)
  • AC = Actual Cost (actual cost of completed work)

Schedule Performance Index (SPI)

This metric measures how efficiently a project is progressing compared to the planned schedule. An SPI greater than 1 indicates the project is ahead of schedule, while a value below 1 indicates delays.

SPI = EV ÷ PV

Where:

  • EV = Earned Value
  • PV = Planned Value (budgeted cost of scheduled work)

Budget at Completion (BAC)

Budget at Completion represents the total approved budget allocated for the entire project. It serves as the financial baseline against which project performance is measured.

BAC = Total Approved Project Budget

Estimate at Completion (EAC)

Estimate at Completion forecasts the project’s expected total cost based on current performance and remaining work.

EAC = BAC ÷ CPI

Estimate to Complete (ETC)

Estimate to Complete calculates the additional cost required to finish the remaining project work.

ETC = EAC − AC

That short formula is the baseline project-controls definition. In consulting and professional services, teams also refresh ETC from remaining hours, rate mix, and open risk, not only from EAC minus actual cost. The operating sections later in this page explain how to calculate, refresh, and review ETC during delivery.

Variance at Completion (VAC)

Variance at Completion estimates whether the project will finish over or under its original budget.

VAC = BAC − EAC

Return on Investment (ROI)

ROI measures how profitable a project is by comparing the net financial gain against the original investment.

ROI = (Net Profit ÷ Cost of Investment) × 100%

Net Profit = Total Benefits − Total Costs

Net Present Value (NPV)

Net Present Value measures the current value of future project cash flows after accounting for the time value of money. Projects with a positive NPV are generally considered financially worthwhile.

Payback Period

The Payback Period measures how long it takes for a project to recover its initial investment through generated cash flow. Shorter payback periods generally represent lower investment risk.

Calculated by accumulating project cash flows until the initial investment is recovered.

Internal Rate of Return (IRR)

Internal Rate of Return is the discount rate that results in an NPV of zero. Higher IRR values generally indicate more attractive investment opportunities.

Work in Progress (WIP)

Work in Progress measures completed work that has not yet been billed to the client. It is particularly useful for milestone-based billing and helps project managers monitor available billable work while identifying potential revenue leakage.

WIP = (1 − (Total Billed ÷ Total Project Billing)) × 100%

Earned Value Analysis (EVA)

Earned Value Analysis combines project scope, schedule, and cost performance to evaluate overall project health. It helps forecast completion dates, final costs, and future project performance.

EVA primarily relies on two key performance indicators:

  • Cost Performance Index (CPI) – measures budget performance.
  • Schedule Performance Index (SPI) – measures schedule performance.

Projects where either CPI or SPI falls below 1 require attention. When both metrics are below 1, the project is typically both over budget and behind schedule.

Further Reading

Utilization Rate

Utilization Rate measures the percentage of available working time spent on billable work. It helps organizations understand how effectively resources are being used.

Utilization Rate = Billable Hours ÷ Total Available Hours × 100%

For example, if your team logs 800 billable hours out of 1,000 available hours, the utilization rate is 80%. Low utilization may indicate excess capacity or too much time spent on internal work.

Realization Rate

Realization Rate measures the percentage of available billable hours that are actually billed to clients, making it particularly valuable for professional services organizations.

Realization Rate = Total Billed Hours ÷ Total Billable Hours × 100%

For example, if consultants have 450 billable hours available but only 315 hours are billed, the realization rate equals 70%. Low realization often indicates lost revenue opportunities.

Realized Rate

Realized Rate combines billing rates with realization to show the effective revenue generated per hour.

Realized Rate = Realization Rate × Billing Rate

For example, if a consultant bills at $120/hour with a realization rate of 75%, the realized rate equals $90/hour. This metric helps evaluate overall resource profitability and pricing effectiveness.

How utilization, realization, and realized rate work together

Utilization rate, realization rate, and realized rate are closely related, but they measure different aspects of resource profitability. Understanding how these metrics build on one another helps project managers identify whether profitability issues are caused by low resource utilization, unbilled work, or ineffective billing rates. The diagram below illustrates how these three metrics connect.

Diagram illustrating the relationship between utilization rate, realization rate, and realized rate in project financial management. Why estimate to complete matters for project forecasting

Estimate to complete (ETC) is the remaining-cost forecast that tells a firm how much money and effort are still required to finish active work. Budget and actual cost describe what was planned and what has already been spent. ETC answers the question delivery leaders ask every week: what will it still take to finish?

SPI Research’s 2026 Professional Services Maturity Benchmark (509 firms) put billable utilization at 66.4% for 2025, the lowest in that survey’s history [1]. Under that pressure, forecasting cannot wait for month-end variance surprises. A rising ETC on fixed-fee work is often the earliest signal that margin will compress before the invoice is issued.

Consulting firms use ETC to:

  • reforecast project margin before the next client checkpoint
  • compare remaining effort against remaining budget and remaining calendar
  • decide whether to re-sequence work, swap roles, or raise a change request
  • roll project-level finish-cost risk into practice and portfolio reviews

ETC is not a replacement for project cost estimation at bid time. Estimation sets the baseline. ETC keeps the forecast honest after work has started.

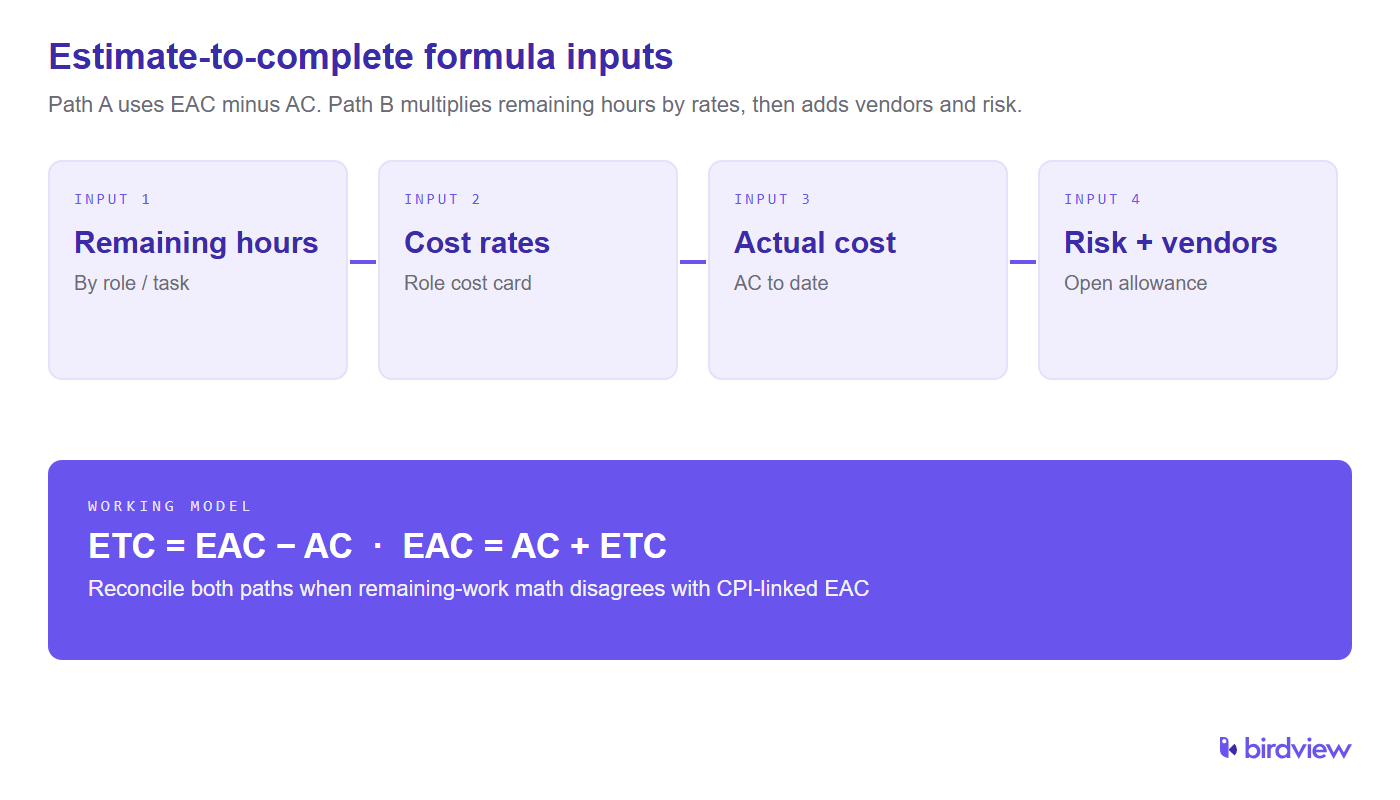

Four inputs behind estimate-to-complete: remaining hours by role, cost rates, actual cost to date, and a risk-plus-vendor allowance, combined into ETC = EAC − AC and EAC = AC + ETC.

There are two common calculation paths. Mature services teams usually run both and reconcile them.

Path A: earned-value path (project controls)

ETC = EAC − AC

Where EAC is estimate at completion and AC is actual cost to date. In earned value management, ETC is the expected cost to finish remaining work, and EAC = AC + ETC keeps the finish-cost model consistent [2]. When EAC is derived from BAC ÷ CPI, this path inherits current cost efficiency into the remaining-cost forecast.

Path B: remaining-work path (services delivery)

ETC = Remaining hours × Blended cost rate + Remaining third-party / expense cost + Open risk allowance

Path B is usually clearer for consulting engagements because remaining hours live in the PSA schedule, staffing plan, or task backlog. Path A is useful when earned value is already running and finance wants a CPI-linked finish-cost view.

Worked example

A fixed-fee implementation has:

  • BAC: $120,000
  • AC to date: $54,000
  • CPI: 0.90
  • Remaining delivery hours: 420
  • Blended internal cost rate: $95/hour
  • Remaining subcontractors: $8,000
  • Risk allowance: $6,000

Earned-value path:

EAC = 120,000 ÷ 0.90 = $133,333
ETC = 133,333 − 54,000 = $79,333

Remaining-work path:

Labor ETC = 420 × 95 = $39,900
+ $8,000 subcontractors + $6,000 risk = $53,900

The gap between $79,333 and $53,900 is the conversation. Either remaining hours are understated, CPI is temporarily distorted, or rate/risk assumptions differ. Do not average the two numbers silently. Document which path is the review number and why the other path disagrees.

In many services firms the phrases are used interchangeably for “remaining cost to finish.” In project controls language, ETC is the formal remaining-cost forecast, often tied to EAC and actual cost. Cost-to-complete (CTC) is the operating label many consulting teams use for the same remaining-cost view when they forecast from remaining effort, burn rate, and risk rather than from CPI alone.

Practical distinction for PSA buyers:

Term Typical question Common calculation lens
Estimate to complete (ETC) How much cost remains to finish? EAC − AC, or remaining work × rates
Cost to complete (CTC) Same operating question in delivery language Remaining effort + burn/risk adjustments
Estimate at completion (EAC) What will the whole project cost in total? AC + ETC, or BAC ÷ CPI
Budget at completion (BAC) What was approved at baseline? Approved budget

If your firm already published a cost-to-complete operating model, keep one glossary and one dashboard field. Dual labels without a mapping table create duplicate forecasts and fake disagreements in review meetings.

EAC is the finish-line number. ETC is the remaining-distance number.

The clean relationship is:

EAC = AC + ETC

and, when using the earned-value finish-cost model:

ETC = EAC − AC

That means every material change to ETC should move EAC, and every change to EAC that is not explained by actual cost already booked should show up in ETC. If EAC rises while ETC stays flat, the model is inconsistent.

For portfolio reviews, pair the two:

  • ETC tells delivery how much work-cost is still ahead
  • EAC tells finance whether the project will miss BAC
  • VAC = BAC − EAC turns the pair into a budget variance call

A usable ETC refresh needs operational inputs, not a spreadsheet guess. Minimum input set:

Input Why it matters Where it usually lives
Remaining hours by role Drives labor ETC Task plans, remaining estimates, staffing board
Cost rates by role Converts hours to cost Rate cards / resource cost fields
Actual cost to date Anchors EAC = AC + ETC Timesheets, expenses, AP
Approved scope / change log Prevents silent scope creep in remaining work Change requests, SOW amendments
Open risks with cost impact Adds allowance where uncertainty is real Risk register
Third-party / expense forecast Captures non-labor finish cost Purchase orders, vendor plans
Billing type (FF / T&M / capped) Changes how ETC maps to margin risk Engagement commercial fields

If any of those inputs are stale, ETC becomes theatre. The fastest failure mode in mid-size firms is remaining hours that nobody updates after standup, while finance still trusts the dashboard number.

On fixed-fee work, revenue is largely locked. Margin moves with cost. That makes remaining work the dominant ETC driver.

When remaining hours climb and fee does not, ETC rise is a direct margin warning. Typical causes:

  • discovery uncovered more integration work than the SOW priced
  • senior time replaced junior time without a rate/budget reset
  • rework after quality issues added hours that were never re-estimated
  • client delay forced idle or context-switching cost into the remaining plan

A practical control: every material remaining-hours change should update ETC the same day, then show EAC and expected margin beside the fixed fee. Waiting for the next monthly finance pack is how fixed-fee overruns become “surprises.”

A rising ETC means remaining cost is growing. It becomes a budget-miss signal when:

  1. EAC = AC + ETC crosses BAC, so VAC turns negative
  2. the rise is driven by approved remaining work, not a temporary estimate noise
  3. commercial recovery (change order, rate uplift, scope cut) is not already booked

Not every ETC increase is a miss. Early discovery can raise ETC while a change request is already in flight. The miss call is EAC versus BAC after commercial path is clear.

SPI’s utilization pressure is the industry backdrop [1]: firms can stay busy and still miss budget when remaining-cost forecasts lag delivery reality. Rising ETC with flat communication to the client is the pattern to interrupt early.

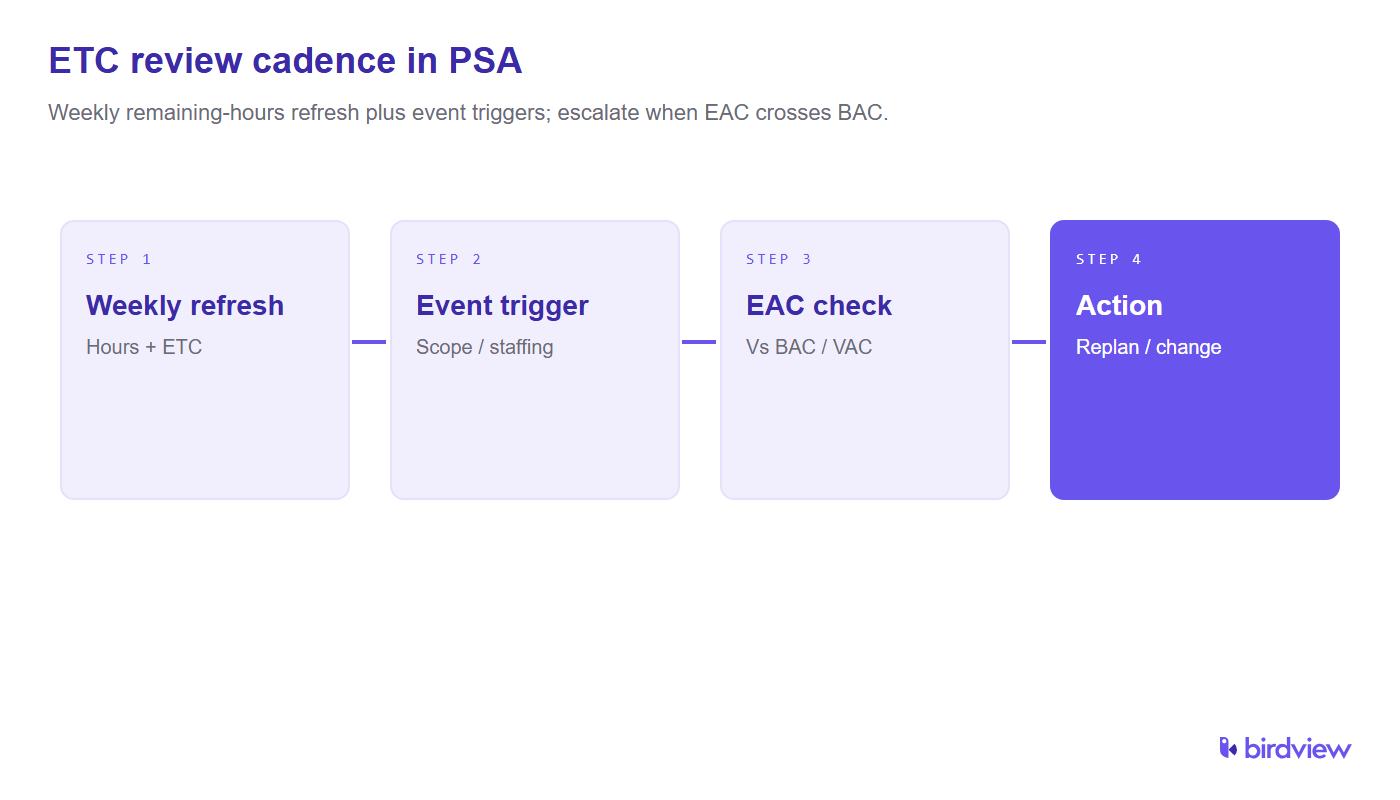

Four-step ETC review cadence: weekly refresh of hours and ETC, event triggers on scope or staffing change, EAC checked against BAC and VAC, then replan or change.

Refresh cadence should match risk, not calendar habit alone.

Cadence When it fits What to refresh
Weekly Active fixed-fee or high-burn projects Remaining hours, ETC, EAC, margin view
Biweekly Stable T&M with clear backlog Remaining work and rate mix
Monthly Low-change retainer / light support Full ETC reconciliation with finance
Event-driven Scope change, major defect, staffing swap Immediate ETC + EAC reforecast

A useful rule: if remaining hours moved more than a set threshold (for example 10% of remaining effort or a fixed hour band), refresh ETC before the next client status. Cadence without event triggers still misses the expensive week.

Yes, if remaining estimates, rates, actuals, and commercial type are in one system. PSA can calculate a live ETC by multiplying remaining hours by cost rates, adding non-labor forecasts, and posting EAC = AC + ETC next to BAC and fee.

What PSA cannot invent:

  • honest remaining hours if PMs never update task estimates
  • risk allowance with no risk register
  • change-order revenue that lives only in email

The automation value is speed and consistency. The management value is still the review: why ETC moved, whether EAC will miss BAC, and what action protects margin. Pair ETC with project budget management and the broader project finances formulas so one forecast language is used across delivery and finance.

Monitor all your project financial metrics in one dashboard

Project financial metrics deliver the most value when they’re monitored continuously rather than calculated manually. A centralized financial dashboard gives project managers real-time visibility into budgets, costs, profitability, utilization, forecasts, and billing progress, helping teams identify financial risks early and keep projects on track.

Birdview project financial dashboard showing revenue, cost, profit, and project financial performance metrics.

Project financial metrics are most useful when they are tracked consistently and reviewed in context. By monitoring budget, cost, revenue, profit, utilization, billing, and forecasting metrics together, project managers can identify financial risks earlier and make better decisions before they affect project profitability. ETC and EAC belong beside those numbers, not in a side spreadsheet.

Why does estimate to complete matter for project forecasting?

ETC is the remaining-cost forecast. It tells leaders how much cost is still ahead, so margin and staffing decisions happen before month-end variance reports.

How do you calculate estimate to complete on a consulting engagement?

Use ETC = EAC − AC for the earned-value path, or remaining hours × cost rates plus expenses and risk for the services path. Reconcile both when they diverge.

What is the difference between estimate to complete and cost to complete?

ETC is the formal project-controls remaining-cost term. CTC is often the same operating idea in consulting language. Keep one mapping so teams do not maintain two forecasts.

How is estimate to complete related to estimate at completion?

EAC = AC + ETC. ETC is remaining cost; EAC is total expected cost at finish.

What inputs do you need to update estimate to complete in PSA?

Remaining hours by role, cost rates, actual cost to date, approved scope changes, open risk allowance, and non-labor forecasts.

How does remaining work drive estimate to complete on fixed-fee projects?

On fixed fee, revenue is mostly locked, so rising remaining hours raise ETC and compress margin unless commercial recovery is approved.

When does a rising estimate to complete mean the project will miss budget?

When AC + ETC pushes EAC above BAC and no change order or scope reset offsets the gap.

How often should PMs refresh estimate to complete during delivery?

Weekly on high-risk or fixed-fee work, plus event-driven refreshes after scope, staffing, or quality shocks.

Can PSA calculate estimate to complete from remaining hours and rates?

Yes, when remaining estimates, rates, and actuals are current in one system. PSA automates the math; teams still own remaining-hour honesty.

  1. SPI Research, 2026 Professional Services Maturity Benchmark (2025 billable utilization 66.4%; 509 organizations): https://spiresearch.com/reports/2026-ps-maturity-benchmark/
  2. Project Management Institute, Earned Value Management Systems Analysis (ETC as expected cost to finish remaining work; EAC = AC + ETC): https://www.pmi.org/learning/library/earned-value-management-systems-analysis-8026

Streamline financial management with Birdview’s advanced reporting software

Birdview logo
Nice! You’re almost there...

Your 14-day trial is ready! Explore Birdview's full potential by scheduling a call with our Product Specialist.

The calendar is loading... Please wait
Birdview logo
Great! Let's achieve game-changing results together!
Start your Birdview journey with a short 9-min demo
Watch demo video
